Mossy Nissan
Houston, TX 2009
The project consists of constructing a 64,000 SF addition to the existing dealership. Due to the size and placement of addition, construction was divided into six separate phases that were completed over a two year period. The main strategy for phasing the project was developed by the owner, architect, and contractor to keep the dealership in full operation and allow the owner to occupy each completed phase. As construction progressed, each phase was re-evaluated and adjust for safe operation of the dealership.
Project Journey
Explore the key milestones that marked the evolution of our project from concept to completion.
2007
Phase I

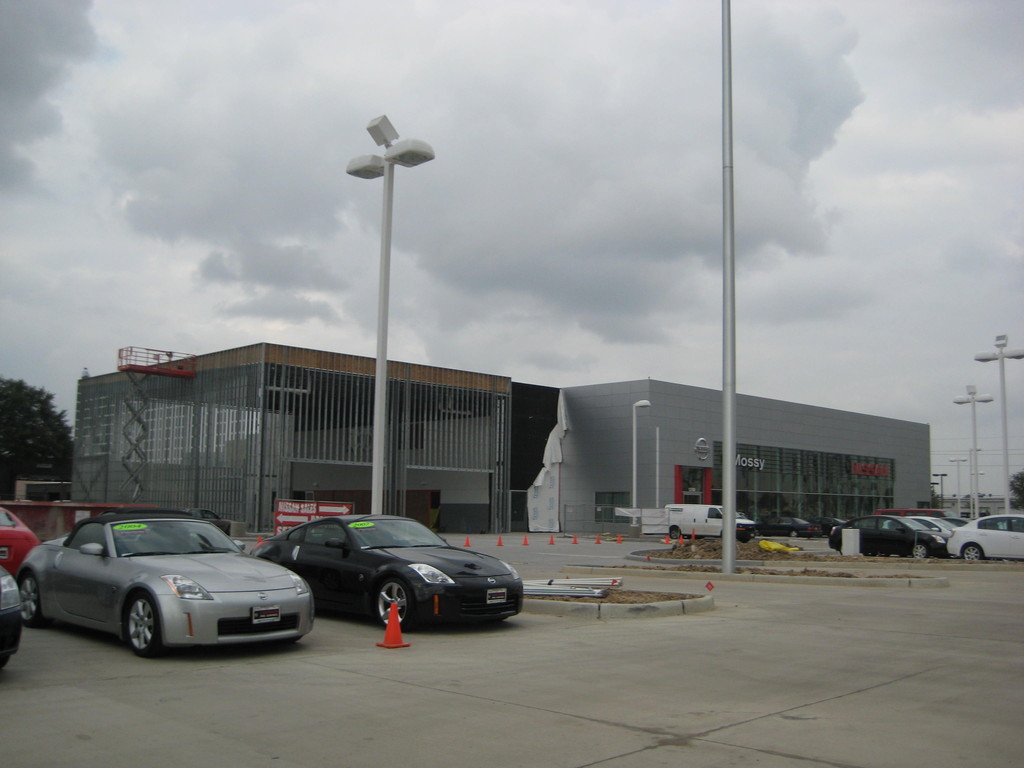

Construction of new car showroom

2007

Phase II

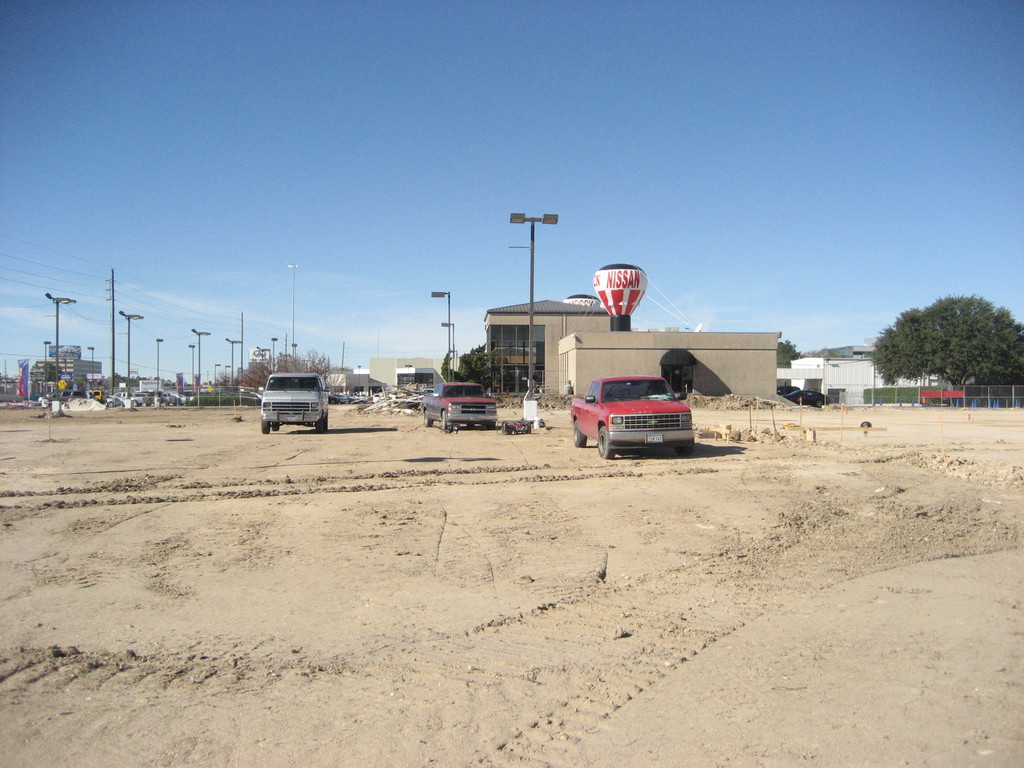

Site preparation for new building
2007
Phase III
Completion of new showroom and sales offices.

2008

Phase IV

Demolition of old showroom and sales offices.
2008
Phase V
Construction of the service and reception center.

2009
